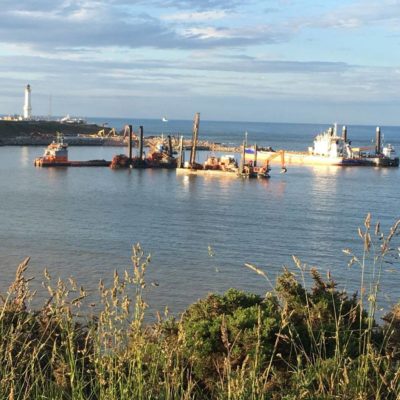

Nigg Bay, Scotland

Nigg Bay, Scotland

The Project for Wasa Dredging’s part started in June 2018, the end client for the project is Aberdeen Harbour, Wasa Dredging acted as a sub-contractor.

Our part of the project is planned to go on until the end of 2019.

The project as a whole consists of a whole new harbor being built, the future harbor basin and fairway is being deepened and widened, two big breakwaters and a number of quays are being built.

Part of Wasa Dredging’s scope is also the filling and levelling of the bedding layer in the caisson trenches, which we partly also blast.

The blasting is very careful due to the underwater noise limits due to nearby mammals (Dolphins/seals) and the vibration limits on nearby concrete and brick outfalls.

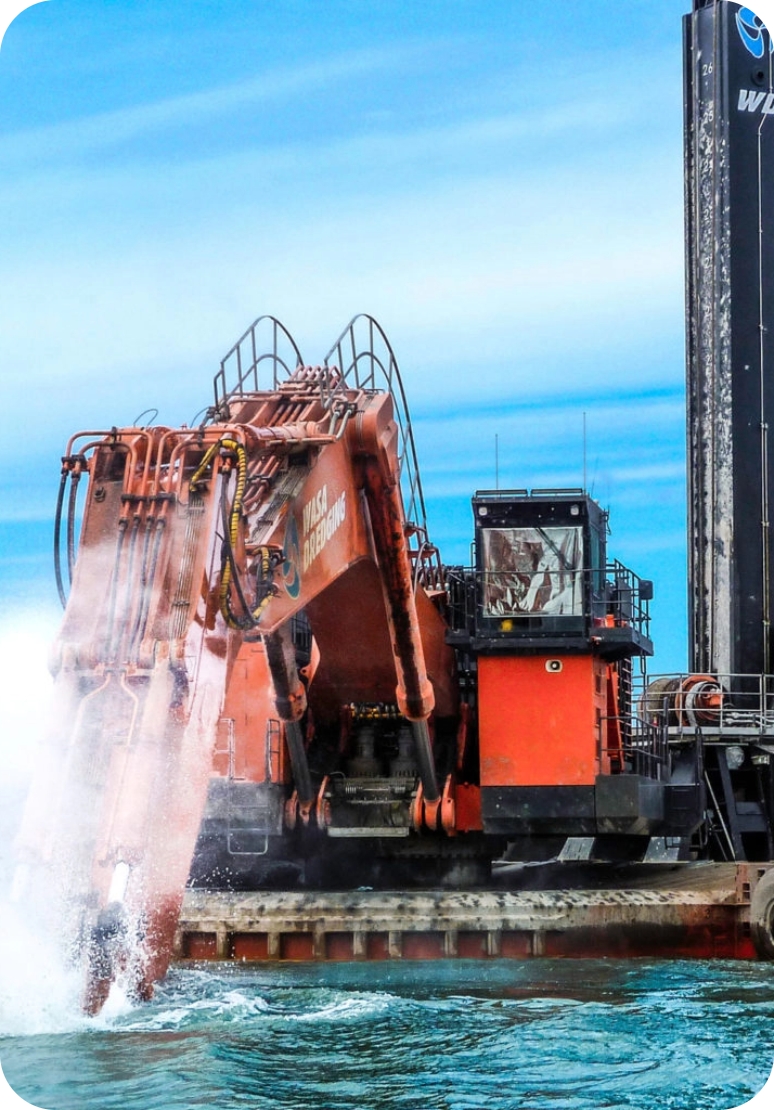

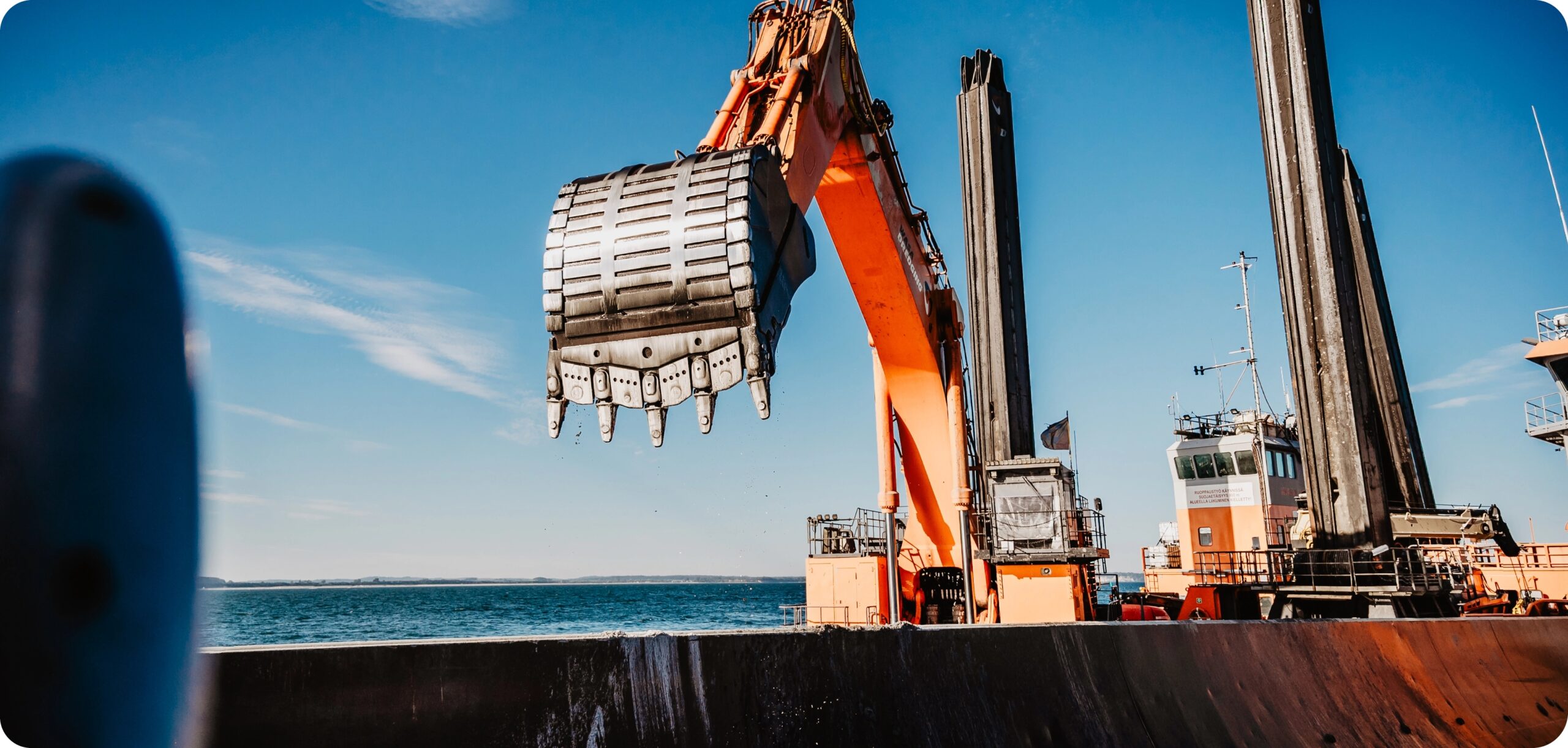

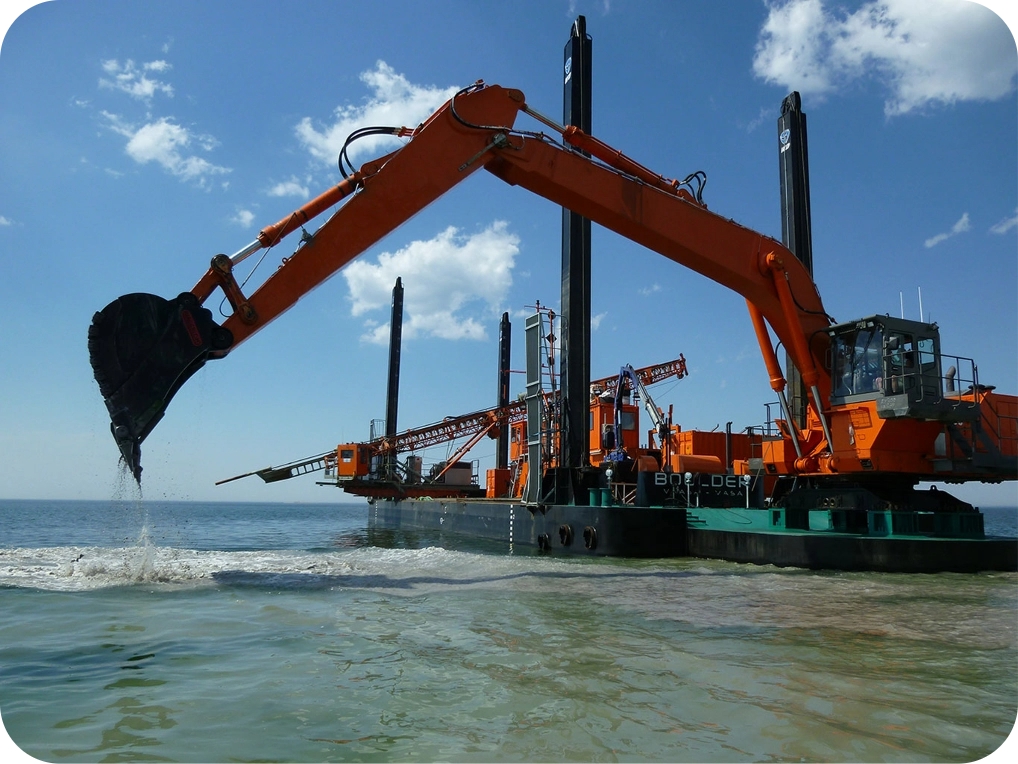

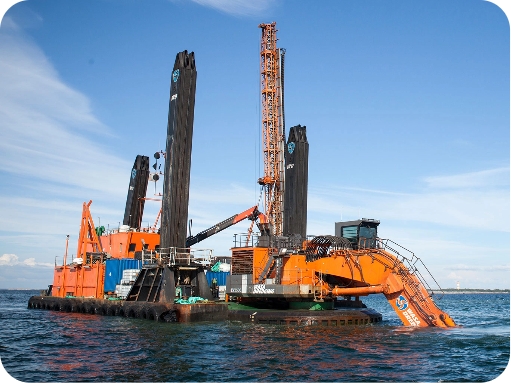

The blasting is mainly taken care of by our combined drilling platform/backhoe dredger “Boulder” while the blasted rock and soft soil dredging is handled by one of our other combined drilling platform/backhoe dredgers “Hector”. The blasted rock is dumped in the core of the two breakwaters that are being built and the softer soils are dumped a few sea miles away in open waters. All masses transported by our self-propelled split-hopper barge “Boann” and towed split-hopper barge “Miika II”.

The bedding layer works in the caisson trenches consists of two layers of differently graded material, very precise underwater filling and levelling operations with tolerances of as little as +5cm/-5cm.

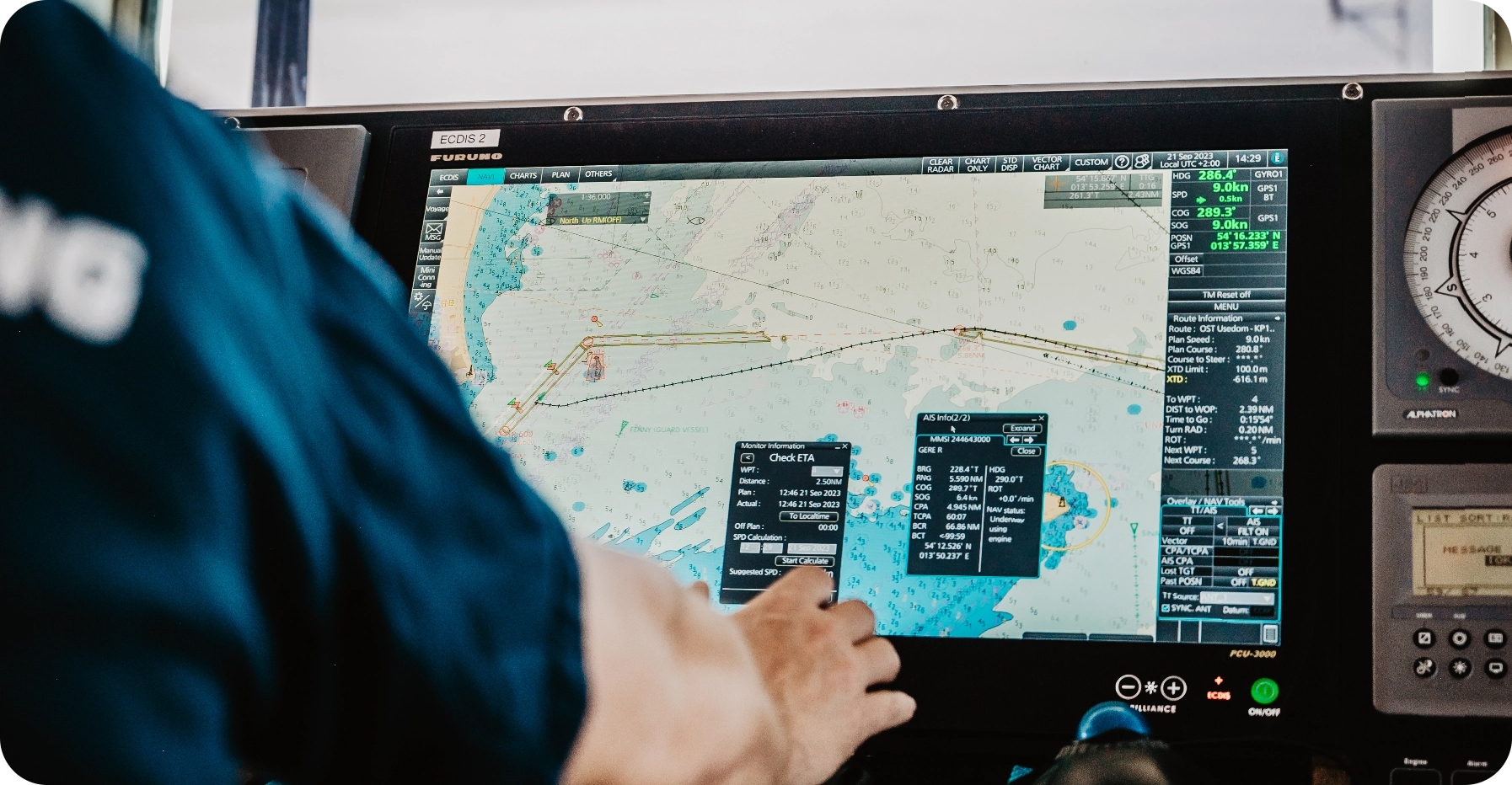

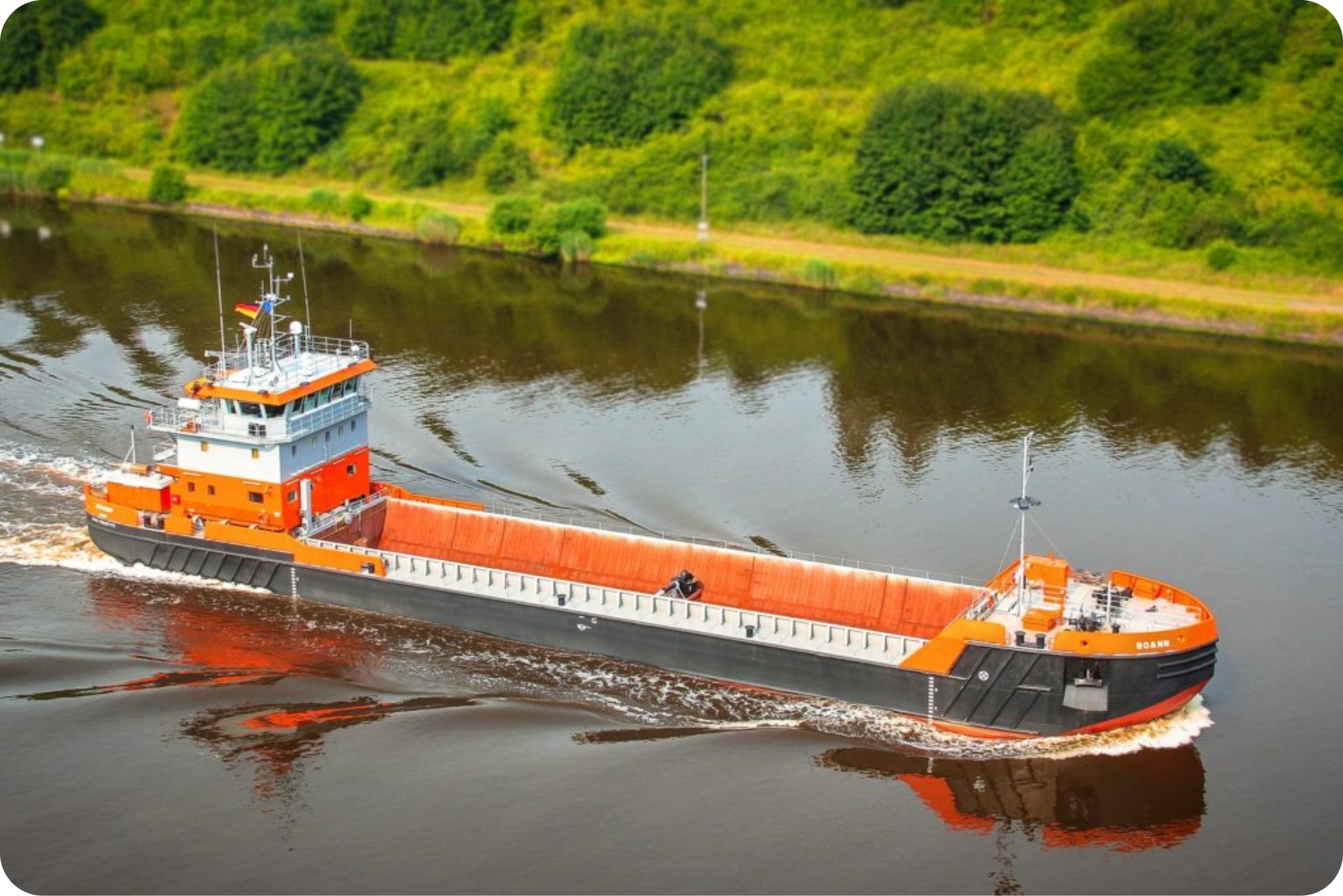

The self-propelled barge “Boann” is filled with material in Aberdeen Harbour before it goes out to Nigg Bay and dumps the material in the caisson trenches according to our calculations.

The levelling of the rougher underlaying layer of filled/dumped material is handled by both the dredgers “Hector” and “Boulder”, whichever is free to do so at the time.

The more precise levelling of the finer material in the top layer is handled by our levelling pontoon “Kampela II” pushed by a tugboat.

Client
Dragados UK Limited
Project Timeline
July 2018
Location
Nigg Bay, Scotland
Facts
Dredging [m3] 120 400 of blasted rocks
Rock blasting [m3] 680 000 moraine of soft soils

Over 200 successful projects – and counting

Our extensive know-how of the dredging market and continuous renewal and improvement of our in-house designed equipment ensures that we will always have the right tool for the job at hand.
